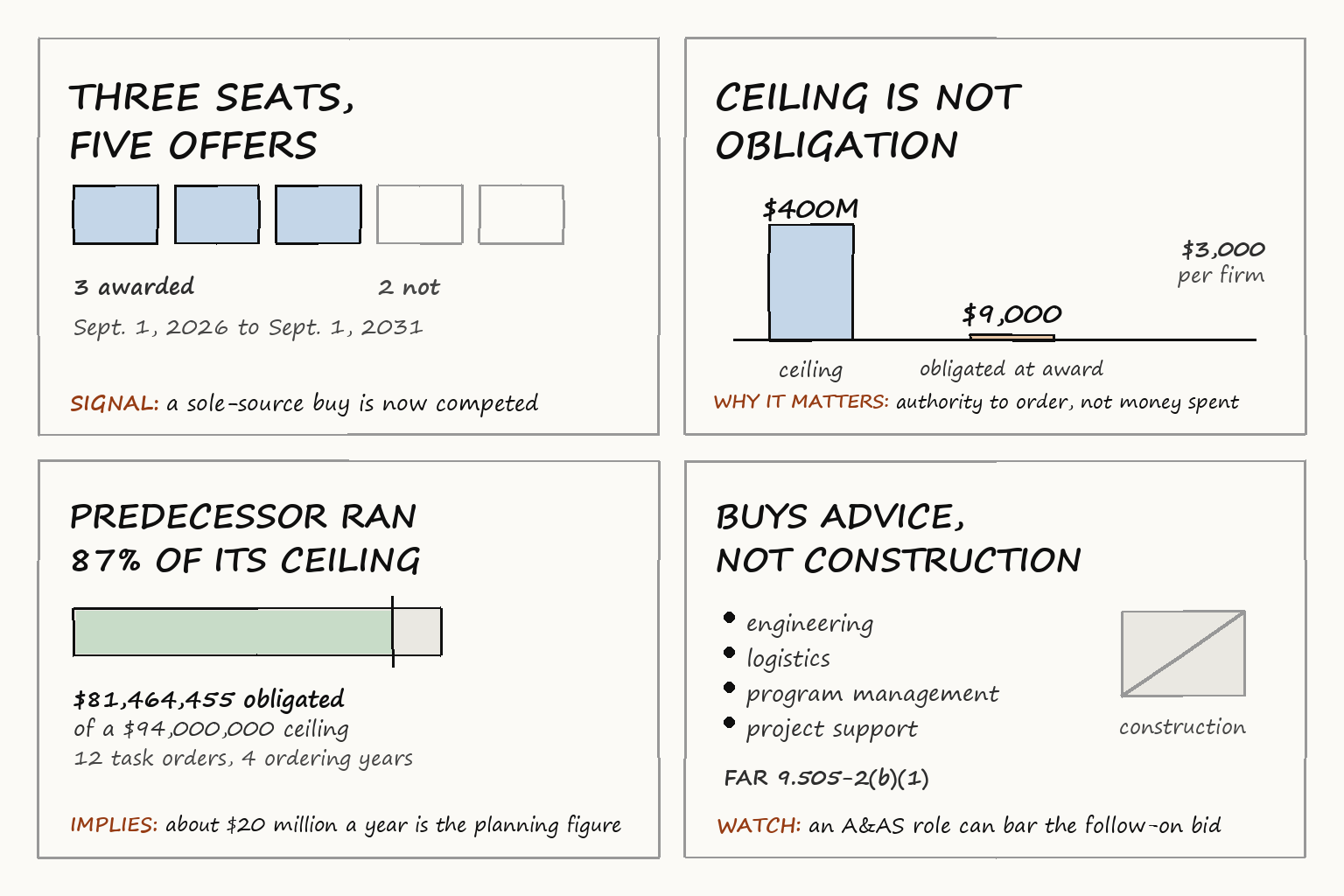

What the PACAF Civil Engineering IDIQ Buys, and What It Obligated on Day One
If you run a small or mid-market engineering services firm in the Indo-Pacific, your path into the new PACAF civil engineering IDIQ is a subcontract. That window closes during the first task-order cycle. Three companies hold every seat until 2031. The Air Force awarded the multiple-award indefinite-delivery, indefinite-quantity (IDIQ) contract on Sept. 1, 2026. The winners are Cherokee Nation Government Solutions, SSE BB&E JV and KIRA Services. The combined ceiling is $400 million. The work is advisory and assistance services (A&AS): engineering, logistics, program management and project support, not construction. Nine thousand dollars was obligated at award, $3,000 per firm, the guaranteed minimum. Size your capture plan against roughly $20 million a year, split three ways. That was the predecessor’s ordering pace from 2020 to 2024.
| Field | Answer |
|---|---|
| Signal | Three seats on a $400 million Pacific civil engineering A&AS ceiling, awarded Sept. 1, 2026 after five offers |
| BD implication | A requirement that ran sole-source for five years is now competed, and the seats are set until Sept. 1, 2031 |
| Customer | Pacific Air Forces civil engineer staff and base-level squadrons across Hawaii, Guam, Japan, Alaska and Wake Island |
| Buyer | The 766th Enterprise Sourcing Squadron, Joint Base Pearl Harbor-Hickam. Task orders may be issued by Department of War Pacific theater contracting offices |
| Funding | $9,000 obligated at award, $3,000 per firm, against a $400,000,000 ceiling. The predecessor obligated $81,464,455 across twelve task orders |
| Vehicle / path | Multiple-award IDIQ: FA521526D0001, FA521526D0002, FA521526D0003. Ordering Sept. 1, 2026 to Sept. 1, 2031. Without a seat, the path is subcontract or teaming |
| Incumbents / ecosystem | The three holders. Cherokee Nation Management & Consulting held the predecessor. Two unsuccessful offerors are not named |
| Access strategy | Approach the holders’ capture organizations against the base-level requirements the predecessor’s task orders covered, before the first orders compete |
| Timing | Ordering opened Sept. 1, 2026. Set-aside and industry coding stay out of public view for 90 days after signature. Offeror identities carry no release date |
| Confidence | High on the award facts and the predecessor’s obligations. Moderate on demand forecasting, which rests on a 2020 to 2024 pace across a two-year ordering gap and on appropriations still at request stage |
| Pursuit posture | TEAM for engineering services subcontractors. WATCH for mid-market firms tracking the next recompete. DEFEND for Cherokee Federal. IGNORE FOR NOW for architect-engineer and construction firms |
| Upgrade triggers | Task orders above the predecessor’s $20 million annual pace appearing in the public record, or fiscal 2027 Indo-Pacific Air Force construction enacted near the $156 million request |
| Downgrade triggers | Enacted fiscal 2027 Indo-Pacific construction more than a third below the $156 million request, or the fiscal 2028 projection not surviving into a budget request |
PACAF’s Previous Civil Engineering Contract Was Sole-Sourced for Five Years and Nearly Full
Cherokee Nation Management & Consulting held the vehicle the new $400 million IDIQ replaces. That contract dates to Sept. 1, 2020, an 8(a) sole source that drew one offer. The ceiling started at $45 million and reached $94 million by modification two months later. One extension pushed ordering to Aug. 31, 2024. Task order performance ran through Aug. 31, 2025. Ordering closed two years before this vehicle opened. A bridge action under a separate contract number most likely carried the requirement in between.
Twelve task orders across 109 contract actions obligated $81,464,455. That is recorded obligation, not ceiling. Against the $94 million ceiling, it works out to 87 percent utilization.
The annual pace behind those obligations, not the percentage, makes the new ceiling a planning figure rather than a promise. Eight of the twelve orders covered $73.3 million of that total:
- Joint Base Pearl Harbor-Hickam support drew $18,966,007, the largest single order.
- A second order, with no installation named, drew $18,209,102.
- A general A&AS order ran to $12,623,168.
- Yokota Air Base, through the 374th Civil Engineer Squadron, drew $8,048,813.
- Misawa Air Base drew $7,387,912, and Kadena Air Base, through the 18th Civil Engineer Squadron, drew $4,468,296.
- Eielson Air Force Base and an Alaska Air National Guard civil engineer squadron drew $3,186,143 and $371,307.
The predecessor averaged roughly $20 million a year across four ordering years. Hold that pace and the new PACAF civil engineering IDIQ finishes near a quarter of its ceiling. That is about $33 million per holder over five years. Double the pace and the vehicle finishes at half, about $67 million each. An even split of the full $400 million would be $133 million apiece. For a DIB sub without a seat, model revenue on the $33 million to $67 million range, not the $133 million split.
Three Seat-Holders, Two Unnamed Offerors, and One Adjacent Contract Just Ending
All three winners are Native-owned small businesses. Cherokee Nation Government Solutions is a Cherokee Nation company. SSE BB&E JV pairs SpecPro Sustainment and Environmental with the engineering consultancy BB&E. SSE is a subsidiary of Bristol Bay Native Corporation. KIRA Services belongs to Tlingit Haida Tribal Business Corporation, which the Tlingit and Haida Indian Tribes of Alaska wholly own.
Two firms competed and lost. Their identities sit outside the contract action report, so no publication date applies to them. FAR 16.505(b)(1)(i) requires a fair opportunity for each awardee on orders above the micro-purchase threshold. The exceptions to it sit at 16.505(b)(2). Each holder has to win the work against the other two.
One adjacent instrument matters. Cherokee Nation Strategic Programs held a separate 8(a) sole-source contract for Pacific installation geospatial support. Its ceiling was $28,486,340, with $24,594,052 obligated. Ordering finished Aug. 31, 2026, one day before this vehicle opened. The Cherokee Nation’s federal businesses, grouped under the Cherokee Federal brand, held two concurrent sole-source Pacific installation-support instruments. One just converted into a competed acquisition vehicle. If you hold Pacific installation support bought through this same squadron on a sole-source 8(a) instrument, the conversion suggests that a similar Pacific installation-support requirement could return as a competed multiple-award action. One conversion is one data point. The geospatial requirement’s disposition sits inside the same 90-day reporting delay and is not public yet.
Wake Island Sits on the Location List, and $129 Million of Requested Construction Points There
The named places of performance span Joint Base Pearl Harbor-Hickam, Andersen, Kadena, Yokota, Misawa, Eielson, Joint Base Elmendorf-Richardson and Wake Island. Wake does not fit the predecessor’s pattern. Every predecessor task order sat at a manned main base with its own civil engineer squadron. Wake has none, so engineering support there has to be contracted.
Air Force military construction inside the Pacific Deterrence Initiative is requested at $156,000,000 for fiscal 2027. That request funds two projects. One is $129,000,000 for the first phase of an aircraft parking apron at Wake Island. The other is $27,000,000 for a runway extension at Yap Airfield in Micronesia. Both support Agile Combat Employment, the Air Force scheme for generating airpower from networks of smaller fields rather than a few large ones. No stated requirement links the apron project to the vehicle’s Wake Island listing. The timing still lines up.
| Fiscal year | Air Force military construction under the Pacific Deterrence Initiative | Funding status |
|---|---|---|
| 2025 | $162,350,000 | Prior year, no status stated |
| 2026 | $460,150,000 | Prior year, no status stated |
| 2027 | $156,000,000 | Request |
| 2028 | $1,169,000,000 | Outyear projection |
| 2031 | $41,000,000 | Outyear projection |
Three cautions:
- The initiative is a budget display, not the whole Pacific construction program.
- Main-base work at Kadena, Yokota and Misawa runs through other accounts, and in Japan partly on host-nation funding.
- The fiscal 2028 figure is an outyear projection, neither requested nor appropriated.
The appropriation behind these task orders remains undisclosed. Treat construction enactment as a leading indicator, not a funding line. Aim your positioning at fiscal 2027 and 2028 planning and design work.
This Vehicle Buys Advice, Not Construction, and the Difference Can Cost You a Bid
The predecessor’s task orders were coded as program management and engineering technical support, not construction. The work is:
- Programming documents and cost estimates.
- Project management and inspection.
- Community planning and real property analysis.
This award is not a construction pipeline. Chasing it as one aims your bid at the wrong instrument.
The distinction has teeth. Under FAR 9.505-2(b)(1), a contractor that prepares or assists in preparing a work statement for a competitive acquisition may not supply the resulting services. Narrow exceptions apply. A firm writing the requirement for a Wake Island apron package can be barred from bidding it.
How a dollar reaches a subcontractor:
- A base civil engineer squadron or Pacific Air Forces staff element builds and funds a requirement.
- A contracting officer at a Pacific theater office competes the order among the three holders under fair opportunity.
- The winning holder performs with its own team, including subcontractors named at proposal.
- The contracting office records the obligation, which reaches the public record 90 days later.
Your name has to be on a holder’s team at step three, so the conversation happens before step two.
What a Firm Without a Seat Does Between Now and 2031
The three awarded seats control prime access to the vehicle through the current ordering period. Firms without a seat therefore enter through teaming with a holder or the next recompete. What you do about that differs by segment.
- Founders and BD leads at small business DIB subs in engineering or facilities: approach the capture organizations at all three holders this quarter, positioned against a named installation rather than a general capability statement.
- Mid-market firms without a seat: work back from the Sept. 1, 2031 expiration. This acquisition ran about 31 months from sources-sought to award, which puts the next shaping window near early 2029. Build Pacific theater past performance before then.
- Architect-engineer and construction firms: keep this vehicle out of your construction pipeline, and check any A&AS role against FAR 9.505-2(b)(1).
- Pull your own award history for the last three years and mark every Pacific theater program management or engineering support order.
For an engineering services subcontractor the near-term move is teaming, not pursuit. Two events should serve as decision points. The first is task orders clearing the predecessor’s $20 million annual pace in year one. The second is enacted fiscal 2027 Indo-Pacific construction landing near the $156 million request. If enacted construction lands more than a third below that, the demand case thins. The same follows if the fiscal 2028 projection does not survive into a budget request.
FAQ
Who owns the budget behind these task orders?
The base civil engineer squadrons and the Pacific Air Forces civil engineer staff build and fund their own requirements. That is why the predecessor’s orders came from several offices rather than one. The appropriation those requirements draw on remains undisclosed.
Which incumbent is positioned at each installation?
Cherokee Federal holds working relationships at Joint Base Pearl Harbor-Hickam, Yokota, Misawa, Kadena and Eielson, built through the predecessor’s twelve task orders. The other two seat-holders start those installation relationships from zero. That gap is where a subcontractor with local past performance has an opening.
Which contracting shops and program offices matter here?
The 766th Enterprise Sourcing Squadron at Joint Base Pearl Harbor-Hickam manages the contract. The predecessor’s orders came from four office codes, including one Army-coded office serving an Air National Guard squadron. Your counterparties are the base civil engineer squadrons at Kadena, Yokota, Misawa, Eielson and Joint Base Pearl Harbor-Hickam.
Was this a small business set-aside?
The set-aside type publishes with the contract coding, 90 days after the signature date. Until then it remains undisclosed. All three awardees are small businesses, and the acquisition was competitive with five offers.
Which adjacent Pacific installation-support instrument comes up next?
Cherokee Nation Strategic Programs held a geospatial support contract for the same theater. Its ordering finished Aug. 31, 2026. A recompete, a move into another vehicle, or a dropped requirement would each surface on the same 90-day clock.
What are the next observable events worth watching?
A modification adding awardees would change the access picture. That modification and an acquisition or novation of a seat-holder are the only two routes onto the vehicle itself before 2031. Neither carries a published trigger, so a protest of the award is the nearer-term event to watch.
