HomeProcurementThe M1156 Precision Guidance Kit Contract Is Now an $863M Ceiling, Not...

The M1156 Precision Guidance Kit Contract Is Now an $863M Ceiling, Not a Priced Option Ladder

The predecessor priced quantities at award and drew them down through numbered options. The successor commits to no quantity and no price, making its larger ceiling a weaker signal of actual demand.

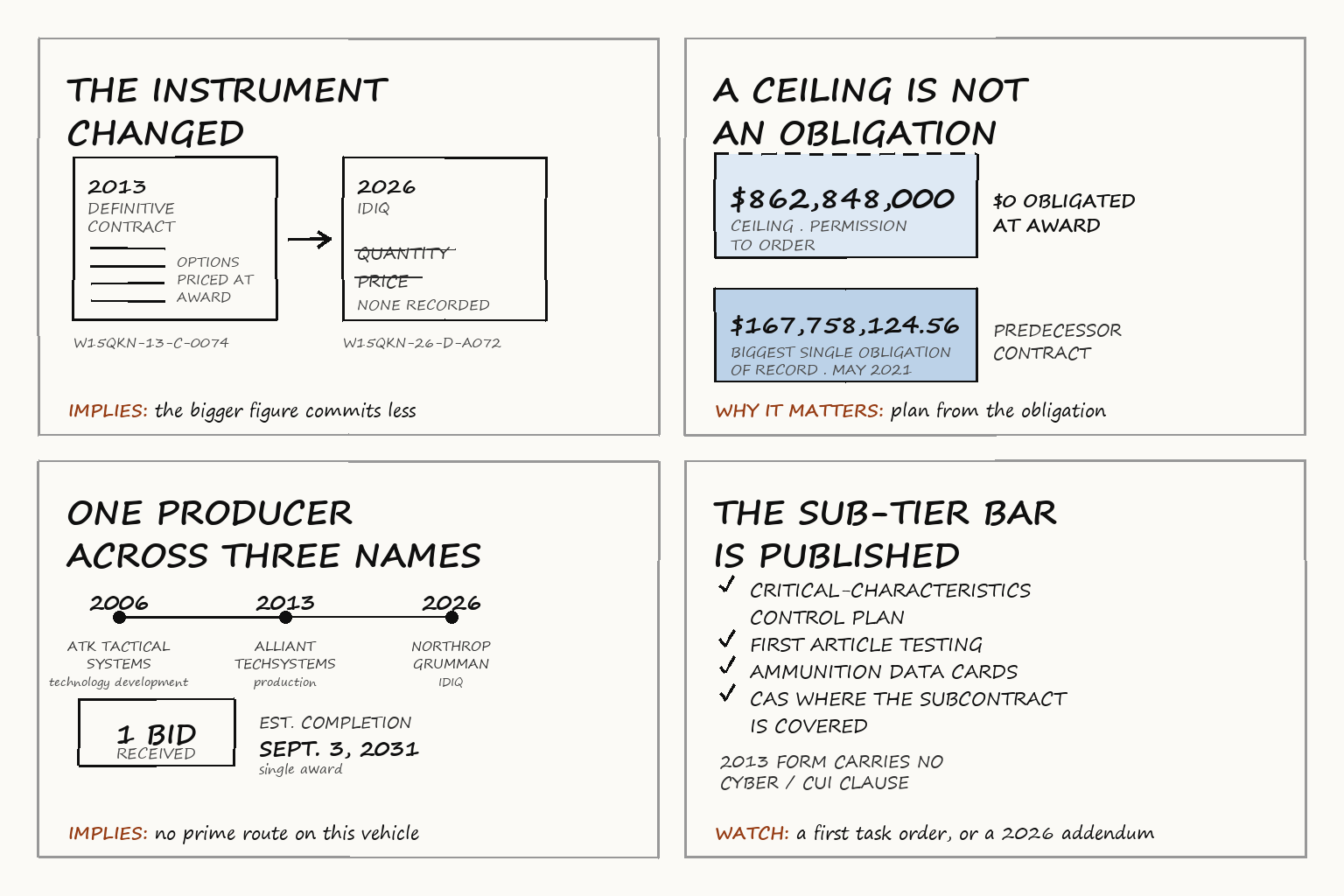

What the M1156 Precision Guidance Kit Contract Changed on Sept. 3, 2026

If you sell guidance electronics, gun-hardened assemblies or energetics-adjacent components into the 155mm artillery supply chain, the M1156 precision guidance kit contract is a subcontract target. The prime seat is closed. Army Contracting Command, Newark, New Jersey, awarded the vehicle to Northrop Grumman Systems Corp. of Minneapolis, Minnesota. It is a firm-fixed-price indefinite-delivery/indefinite-quantity contract for M1156 kits and variants, with an estimated completion date of Sept. 3, 2031. The figure is $862,848,000, a ceiling, not obligated spend. The Army solicited bids via the internet and received one. Funding is set with each order, so no quantity and no obligation attached at award. The kit is a GPS-guided fuze that threads into a 155mm projectile’s fuze well and steers an unguided shell.

Field Answer
Signal A $862,848,000 ceiling awarded Sept. 3, 2026 from one bid, where the 2013 contract carried priced options
BD implication Priced quantities gave way to an open ordering vehicle that commits less
Customer The Army, Marine Corps and Foreign Military Sales quantities the 2013 production scope named
Buyer Army Contracting Command, Newark, New Jersey, with the Picatinny contracting office recorded on the earlier contract actions
Funding No obligation or minimum quantity recorded at award, and no appropriation line attaches to the vehicle
Vehicle / path Firm-fixed-price IDIQ, contract W15QKN-26-D-A072
Incumbents / ecosystem Northrop Grumman Systems Corp. is its own incumbent, after ATK Tactical Systems and Alliant Techsystems Operations on this program’s contract record
Access strategy Sub-tier supply to the awardee, against the prime’s published flow-down set
Timing Ordering opened at award, against an estimated completion date of Sept. 3, 2031, not a stated ordering-period end
Confidence Moderate on the award facts, Moderate-High on the predecessor lineage, High on the flow-down clause set, Low on ordering pace
Pursuit posture WATCH for guidance-electronics and precision-fuze suppliers; IGNORE FOR NOW for prime hopefuls
Upgrade triggers A first task order against W15QKN-26-D-A072, or publication of the new vehicle’s flow-down addendum
Downgrade triggers A protest, or an ordering year with no recorded task orders

Three things differ from the predecessor contract:

  • The headline figure is larger than the biggest single obligation the predecessor’s award record puts a number on, $167,758,124.56 in May 2021. That is a ceiling against an obligation, not a like-for-like increase.
  • The instrument changed from a definitive contract with options to an indefinite-delivery vehicle.
  • Every recorded production action since 2013 sits with one production line, and the 2006 development award went to an ATK entity.

From Priced Options to an Open Ceiling, the Instrument Changed

The predecessor was not an IDIQ. Contract W15QKN-13-C-0074, awarded Aug. 30, 2013 against solicitation W15QKN-12-R-0065, was a firm-fixed-price definitive contract for M1156 production. It carried a numbered option ladder the Army drew down over more than a decade. One modification in May 2021 carried Options 6, 7 and 8 onto the contract and exercised the sixth. Option 8 exercises followed in June 2024 and January 2025.

No record cross-references the two contract numbers. The succession here is an inference rather than a stated fact: same office lineage, same program, same producer. Option 8 was the last numbered rung on the record, exercised in January 2025. That left the Army needing a new instrument for further quantities. Why the Army chose an IDIQ over more options is undisclosed.

That structure priced the work at award. A supplier could size a production line against a priced option ladder.

$167,758,124.56 obligated in a single May 24, 2021 modification, which added Options 6, 7 and 8 and exercised Option 6 on the predecessor M1156 production contract.
Attribute W15QKN-13-C-0074, 2013 W15QKN-26-D-A072, 2026
Instrument Firm-fixed-price definitive contract Firm-fixed-price IDIQ
Quantity commitment Priced option quantities set at award None recorded
Single obligation of record $167,758,124.56, May 24, 2021 None
Headline figure Not stated as a ceiling $862,848,000 ceiling, not obligated spend
Named demand set Army, Marine Corps and FMS quantities Kits and variants, order by order

For a BD lead or capture lead, the acquisition vehicle changed and the bigger number became the softer signal. A ceiling with no quantity behind it says less about Army intent than one priced option exercise did. The predecessor’s obligation history is the stronger demand benchmark until task orders establish the successor vehicle’s actual ordering pace.

One Bid Is What a One-Producer Market Looks Like After 20 Years

One bid on a solicitation carrying an $863 million ceiling looks like a fact about contractor appetite. It is not. It is the single-producer market showing up in the bid count. The Army has sourced this kit from one corporate line since the 2006 technology-development award. The modifications carrying the predecessor forward are coded as not competed.

The lineage runs in four steps:

  1. June 30, 2006: The Army awards W15QKN-06-C-0130 to ATK Tactical Systems Company LLC for fuze and primer technology development, obligating $3,978,013 at award plus later modifications obligating $723,642 and $577,365.
  2. Aug. 30, 2013: Production contract W15QKN-13-C-0074 goes to Alliant Techsystems Operations LLC, obligating $57,133,592.24 at award plus a separate $682,438.38 obligated against the same scope.
  3. 2021 through 2025: Options 6 through 8 are added and exercised, with performance recorded in Minneapolis under the Northrop Grumman name.
  4. Sept. 3, 2026: The successor IDIQ is awarded to Northrop Grumman Systems Corp. from one bid.
“Adding new work under Options 6, 7, and 8 and exercise of Option 6 for the M1156 PGK.” (Modification P00077 to contract W15QKN-13-C-0074, May 24, 2021)

A firm with no qualified line for this guided fuze does not bid a five-year production vehicle. One offer is consistent with a market that has never carried a second qualified producer. No record establishes that a second source could not qualify. I would not build a protest theory on a bid count. Stop scoring this scope as a competitive prime opportunity and move the bid-and-proposal budget to the sub-tier route.

Competitive Landscape: One Producer, Three Corporate Names

One producer has held every M1156 production action on the record, under three entity names: ATK Tactical Systems, then Alliant Techsystems Operations, then Northrop Grumman Systems. The 2013 option exercises record performance in Minneapolis. The 2026 award names that same Minneapolis operation as the awardee’s place of business. The competitive position is therefore not prime versus prime.

Where competition does exist here:

  • Sub-tier component competition inside the awardee’s supply chain, re-competed on the prime’s own schedule.
  • Adjacent 155mm precision munitions such as the M982 Excalibur, competing for the same fire-mission dollars.
  • The next competition for this production scope, which the award defers rather than forecloses.

A mid-market defense-electronics supplier competes against whoever already holds a position on the prime’s approved source list. That list is not public, so treat it as unknown, not empty. Competition here has moved down a tier. The DIB prime position is closed for the vehicle’s life, which leaves a contest among DIB subs for content inside the awardee’s bill of materials. The relevant commercial counterpart is the prime’s supply-chain organization rather than the contracting officer.

The Predecessor Contract’s Supplier Qualification Bar Is Published

The qualification bar for sub-tier work here is published in clause-level detail. Northrop Grumman’s own supplier addendum for the predecessor contract sets out what flows down. That six-page form was issued in 2013. No equivalent addendum is published for the 2026 vehicle. Treat the 2013 set as the shape of the bar, not its current text. It carries no cyber or controlled-unclassified-information flow-down, so a 2026 subcontract would add obligations that form never mentions.

What a supplier has to be able to carry:

  • Physical security standards for sensitive arms, ammunition and explosives, plus explosive material handling.
  • Ammunition data cards and first article testing, where either is called out in the order.
  • A critical characteristics control plan submitted to the prime for approval, plus process capability and control requirements.
  • Cost Accounting Standards coverage, where the subcontract is itself CAS-covered and above threshold. Commercial-item work is exempt.
  • Domestic sourcing restrictions on ball and roller bearings, and the hexavalent chromium prohibition.
  • Government property tagging, loss reporting and disposal, plus demilitarization.
  • Contractor employee identification and Level 1 antiterrorism awareness training for work at Picatinny Arsenal.

One clause marks an opening. The 2013 form flows a small business subcontracting plan requirement down to covered subcontracts. That requirement indicates the government found subcontracting opportunity on this scope. The form’s printed threshold has been adjusted upward since, so check the current figure first. The prime’s own plan obligation sits on its prime contract, not this addendum.

Pull your own quality and accounting records before you call anyone. If you cannot show a critical-characteristics control plan and first article test history, you are not a near-term candidate. Closing that gap is your own overhead rather than a bid. Your own subcontract’s CAS status governs, not the prime’s. If you can show both, your opening argument goes to the prime’s supply chain organization.

Foreign Military Sales Is a Live Order Channel on This Program

Allied demand is not a footnote to this program. The predecessor contract carried Netherlands case activity under designators NA36 and NA37 as recently as June 2026. Its 2013 production scope named three separate demand sources: Army, Marine Corps and Foreign Military Sales quantities. Each moves on its own funding route. The 2026 announcement names no ordering customer. Whether allied cases run on this vehicle or beside it stays open.

That changes how you read the ceiling:

  • A ceiling that could absorb allied orders is not a forecast of Army artillery demand.
  • Foreign case orders move with case implementation, not with an appropriation cycle.
  • An allied case can fund kits in a year when the Army buys none.

An order channel that can run on allied cases cannot be timed from the Army’s budget cycle. For guidance-electronics and precision-fuze suppliers, the near-term opportunity is qualification rather than prime pursuit. The 2026 vehicle does not yet establish its sub-tier sourcing or re-qualification requirements. Qualifying now is spending against a future opening, not a response to a live requirement.

Lead time justifies the early spend. A control plan and a first-article history take months to build. A supplier that starts after an order is announced starts behind one that qualified earlier. A first recorded task order against W15QKN-26-D-A072 would show the ordering pace. The new vehicle’s own supplier addendum would show whether the flow-down set moved. A protest, or a first ordering year with no recorded orders, argues for spending capture effort elsewhere.

FAQ

What does the M1156 precision guidance kit contract commit the Army to?

No quantity and no price. The $862,848,000 figure is a ceiling, not obligated spend and not booked revenue. A ceiling is permission to order, not a promise to buy.

What has the Army obligated on M1156 production so far?

The recorded obligations form a floor, not a total. Technology development from 2006 accounts for $3,978,013 plus $723,642 and $577,365. The 2013 production award accounts for $57,133,592.24 plus $682,438.38. The May 2021 modification adds $167,758,124.56. Option 8 exercises in June 2024 and January 2025 carry amounts outside that set.

Which contracting shop matters here?

Army Contracting Command, Newark, New Jersey, is the contracting activity. The earlier contract actions in this lineage record a Picatinny contracting office. The flow-down set references work performed at Picatinny Arsenal.

Can a small business get into the PGK supply chain?

The route is sub-tier supply to Northrop Grumman. The qualification bar sits in the prime’s supplier addendum for the predecessor contract. A small business subcontracting plan requirement flows down to covered subcontracts, at a threshold adjusted upward since the 2013 form. What blocks most entrants is not access but the quality and accounting clause set.

Is there any prime opportunity on this scope before 2031?

There is none on this vehicle, a single award carrying an estimated completion date of Sept. 3, 2031. Three routes are visible, none of them active: a sustained protest, a modification adding holders, or a novation after an acquisition. The Army also keeps options this award does not foreclose, such as buying the scope on a different instrument.

What would invalidate this reading of the award?

Task orders well above the predecessor’s obligation history would argue the ceiling is a demand forecast, not headroom. So would a published minimum quantity or priced ordering schedule. Either moves the posture from watching to teaming.
